Capacitor Cabinet Bulging & Power Factor Penalties? Acrel ANSVG Solves "PV Aftereffect" at Source

Oct 23, 2026

Case Study · PV Aftereffect

Installing photovoltaic systems is intended to save energy and cut operating costs. But after grid connection, many industrial users suffer a sharp drop in power factor and heavy power-factor adjustment penalties month after month. In one Shanghai food seasoning factory, 13 of 40 capacitors bulged and failed completely. The site adopted the Acrel ANSVG static var generator — turning power-factor penalties into rewards within just over one month.

The "Sweet Burden" Brought by PV Systems

The seasoning manufacturer installed on-site solar PV systems in 2026. Solar power is a great green-energy solution, yet several electrical issues emerged after grid synchronisation. The plant's local consumption load is relatively small, so most generated solar power cannot be consumed on site: the active power drawn from the utility transformer decreased significantly while reactive power remained high. During peak sunlight hours, the power factor of two 1600 kVA transformers dropped to around 0.5 and 0.3 — field measurements recorded values as low as 0.37 and 0.49.

0.37 / 0.49
power factor measured at the plant
2 × 1600 kVA
transformers affected by low PF
13 / 40
capacitors bulged & failed
+2%
bill increase per 0.01 PF below 0.90

What does a power factor of 0.3 or 0.5 mean? Utility regulations impose surcharges when the monthly average power factor falls below 0.90. For every 0.01 reduction in power factor, the electricity bill increases by 2%. This results in unnecessary monthly expenses and forces the whole distribution system to operate under unhealthy conditions.

Existing power factor controller displaying 0.37 before retrofit
Before retrofit — power factor 0.37 on the existing controller

Existing power factor controller displaying 0.49 before retrofit
Before retrofit — power factor 0.49 on the existing controller

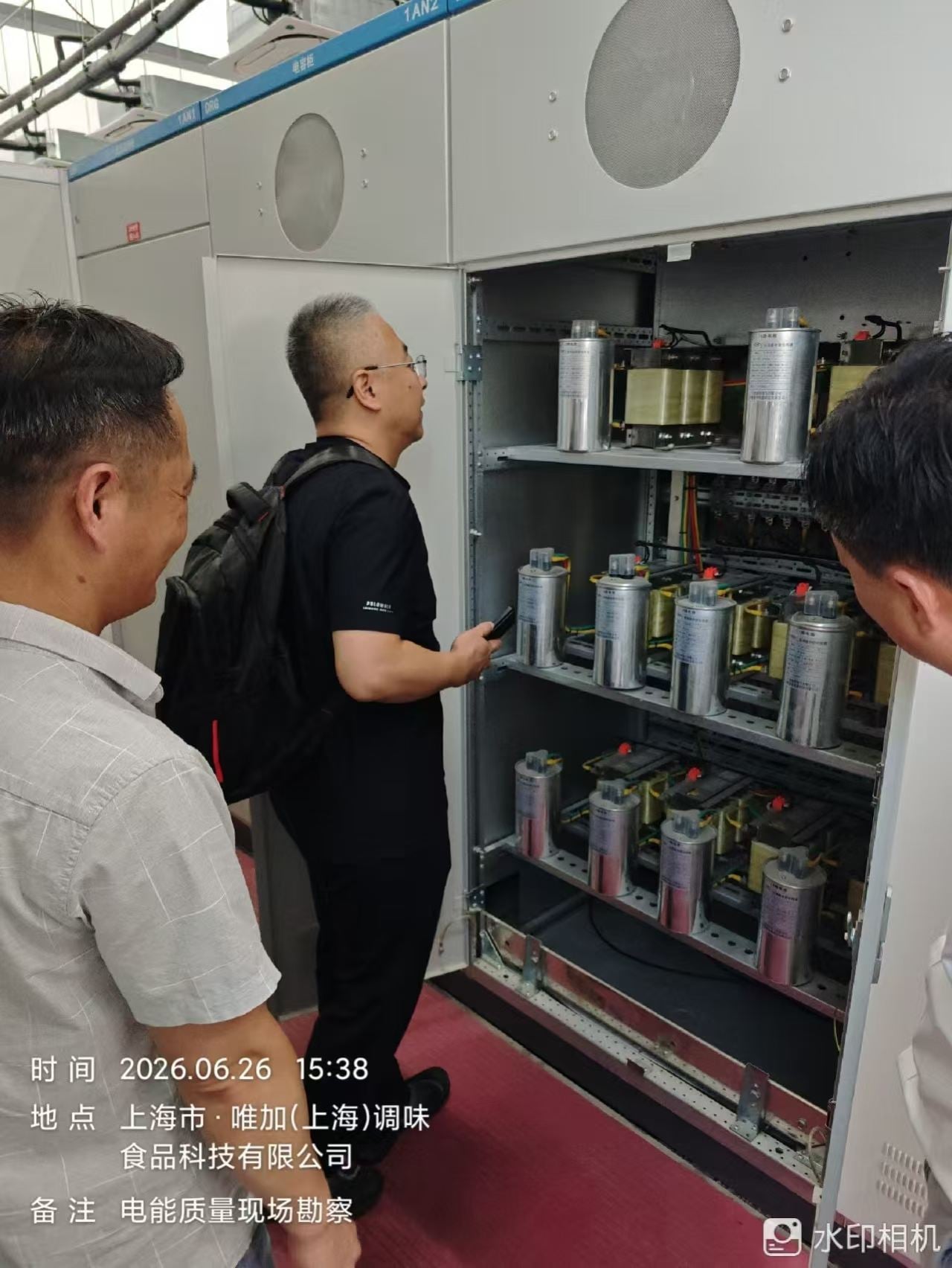

ANSVG static var generator installed at the industrial site
ANSVG units on site
A New Solution: Acrel ANSVG Static Var Generator

Traditional SVC capacitor compensation cabinets rely on mechanical switching of capacitors. They respond slowly, compensate only in steps, and risk harmonic resonance amplification — capacitors easily overheat, bulge and burn out under such conditions. Capacitor banks cannot fully resolve the PV aftereffect. The Acrel ANSVG static var generator offers more suitable compensation technology for PV-connected sites: it injects controllable reactive current into the grid in real time, delivering stepless, bidirectional, millisecond-level compensation.

Fast Response

Response time < 5 ms, tracking load fluctuations instantly and maintaining power factor above 0.95 continuously.

Wide Compensation Range

Continuous adjustment between inductive and capacitive modes — compensates reactive power or absorbs excess reactive power generated by PV systems.

Harmonic Mitigation

Suppresses selected harmonic orders while compensating reactive power, protecting distribution equipment.

Flexible Installation

Modular design with independent operation. A single-unit fault will not shut down the whole system — easy maintenance, high reliability.

Centralized Monitoring

Large touchscreen displays real-time readings of power factor, current, harmonics and other electrical parameters for straightforward status monitoring.

ANSVG cabinet installation
ANSVG cabinet installation

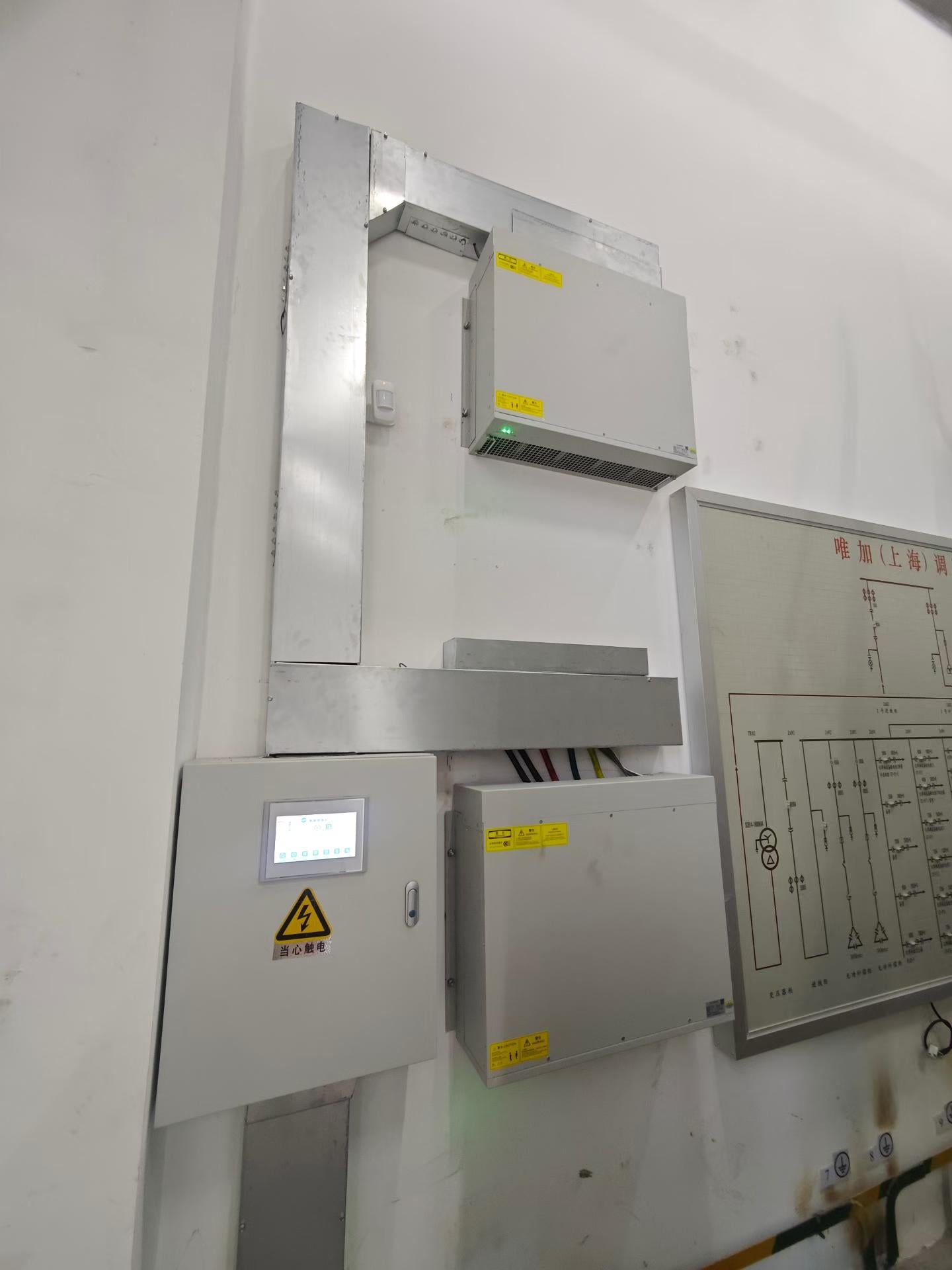

ANSVG units in the distribution room
ANSVG units in the distribution room
Project Implementation: 4 × 150 kVar ANSVG in Parallel

According to on-site load analysis and compensation requirements, Acrel designed a parallel ANSVG solution for this factory. Each of the two 1600 kVA transformers is equipped with 2 units of 150 kVar ANSVG, 4 units in total, replacing the original SVC capacitor compensation cabinet.

  • Transformer #1 — 2 × 150 kVar ANSVG provide linear real-time reactive compensation and stabilise power factor above 0.95.
  • Transformer #2 — 2 × 150 kVar ANSVG eliminate utility power-factor penalties.
Project Results: Power Factor from 0.47 to 1.00 — Penalties Turned into Rewards

Field data recorded by the ANSVG touchscreen shows remarkable results. Before retrofit, the load-side power factor of Unit 1 was 0.47; after commissioning, the grid-side power factor reached 1.00. Unit 2 saw the load-side power factor rise from 0.60 up to 1.00 on the grid side.

Before · Load Side
0.47
Unit 1
→
After · Grid Side
1.00
Unit 1 · 2026-08-03
Before · Load Side
0.60
Unit 2
→
After · Grid Side
1.00
Unit 2 · 2026-08-03

The utility invoice shows tangible economic benefits. According to the official power bill of July 2026:

0.97
Metering point #1 — actual PF (requirement 0.90), rewarded PEN 674.87
0.99
Metering point #2 — actual PF (requirement 0.90), rewarded PEN 1,063.53
≈ PEN 21,000
estimated annual saving on power-factor charges
PEN 1,738.40 total monthly power-factor reward — heavy monthly penalties eliminated, PV benefits fully retained.

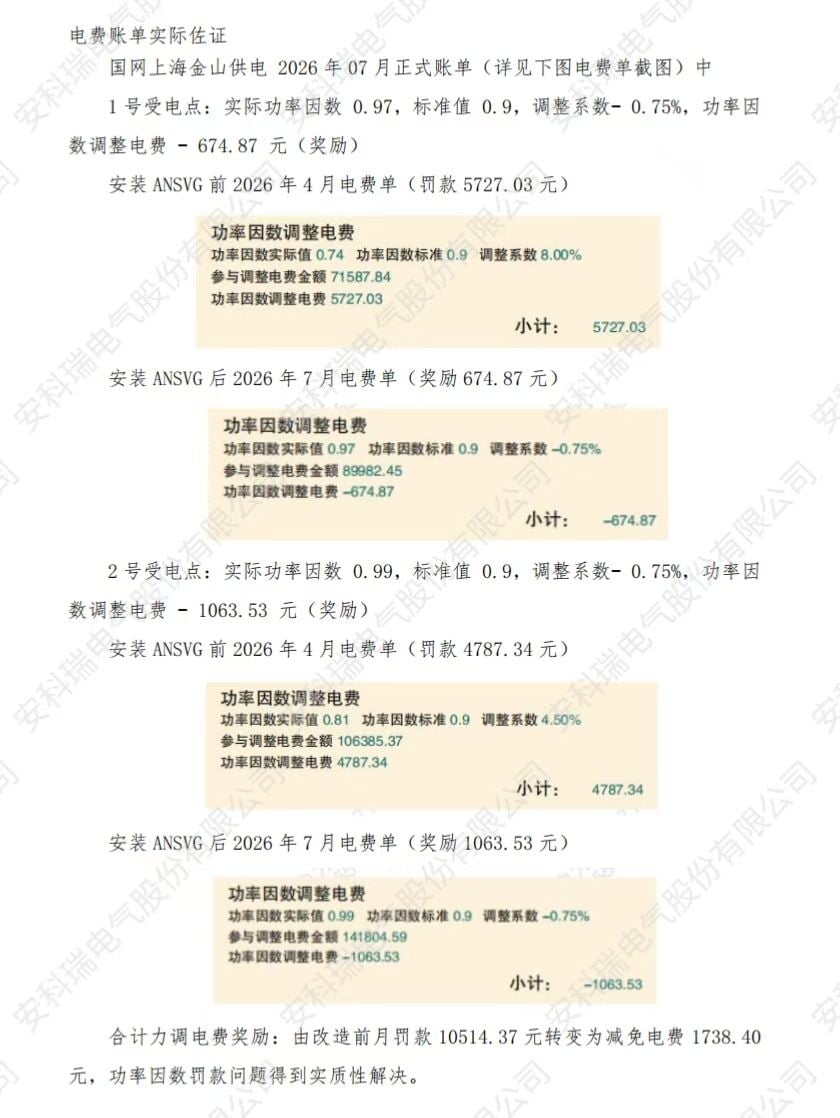

Utility bill evidence: power factor adjustment charges before and after ANSVG
Official utility bill — power-factor adjustment charge: from heavy penalty to monthly reward
Results at a Glance Before ANSVG After ANSVG
Grid-side power factor 0.47 / 0.60 1.00
Monthly power-factor charge Heavy penalty Reward PEN 1,738.40
Capacitor failures 13 of 40 bulged Eliminated
Estimated annual saving — ≈ PEN 21,000

Additional long-term benefits include eliminating capacitor bulging failures, transformer loss reduction and line energy saving.

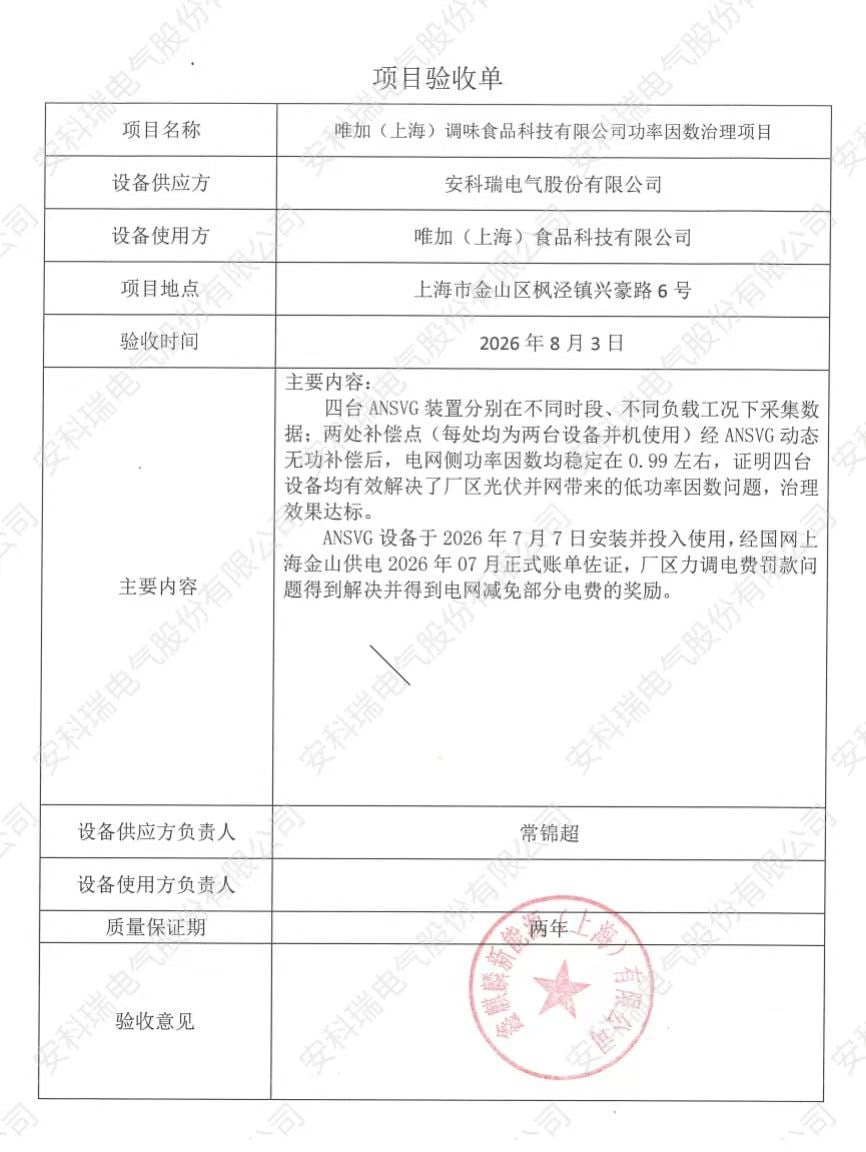

Project acceptance certificate for the power factor improvement project
Project acceptance certificate — grid-side PF stabilised at 0.99

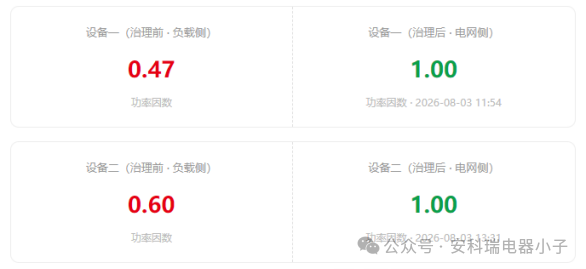

Power factor before and after comparison on ANSVG touchscreen
ANSVG touchscreen — before vs after comparison
Certified Technology
ANSVG invention patents and software copyrights
Multiple invention patents, software copyrights, utility-model and design patents

The Acrel ANSVG series holds multiple authorised invention patents, software copyrights, utility-model and design patents, ensuring reliable quality for every delivered unit.
